SUMMARY OF CONSTRUCTION WORK:

07/15/2026 Project Update.

Construction Bulletin – Cross Lanes Project-Traffic Switch Update

Weekly Status:

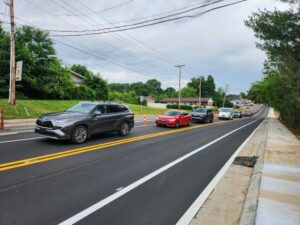

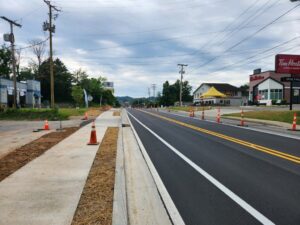

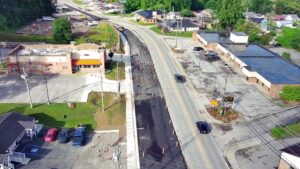

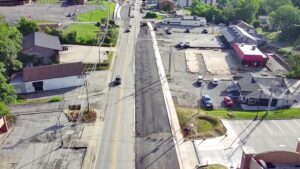

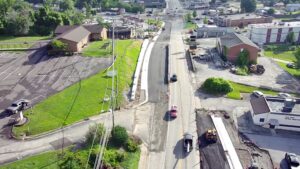

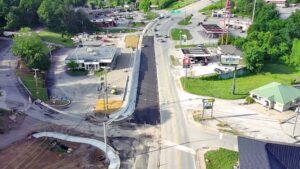

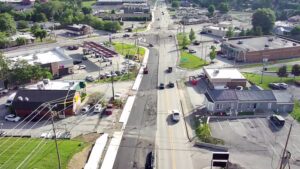

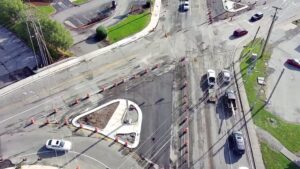

Paving operations continue, with asphalt placement currently prioritized in critical areas where grade transitions and drop-offs are present. Crews are placing asphalt in staged lifts, including the initial base asphalt courses needed to build the roadway section to the required elevations and establish smoother transitions through the active widening limits. Additional base asphalt will be placed as needed to correct grade changes, improve tie-ins to existing pavement, and provide a stable surface for traffic during the current phase of construction. The anticipated traffic switch will take place in the early am hours of 7/20/2026.  Attached to the email is a schematic that will provide a layout of the new traffic pattern.  This switch will be the last major switch and begin the final phases of the project.  During this switch, work will be completed for the widening portioning of the project.  This phase is anticipated to last until the fall of 2026.

Beginning 7/16 and 7/17 lane shifts will be utilized to aid in establishing a new traffic pattern that will be utilized beginning in the AM hours of 7/20/2026.




Upcoming Work / Night Operations:

  • Night operations are anticipated to continue throughout the project lifecycle to support production, maintain traffic flow, and help advance the work toward potential completion ahead of the current March 2027 contract completion date.
  • During night shifts, crews will continue work activities being performed during daytime operations, including paving support, grading, drainage, utility, electrical, lighting, and traffic control activities as needed to maintain progress and improve overall project efficiency.
  • Night work will also be used to complete activities that are more efficiently or safely performed during lower-volume traffic periods, helping reduce daytime impacts while supporting the project schedule.

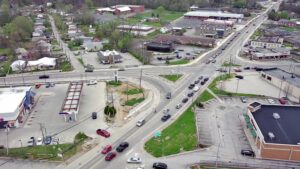

Paving will be performed behind cones and at WV622 and 62 intersection.  Flaggers will be used to aid in this process during night shift work.


General Notes:

  • Nighttime lane closures and traffic shifts are expected to continue as construction progresses.
  • Additional updates will be provided as significant project milestones are reached.

SUMMARY OF TEMPORARY TRAFFIC CONTROL:



 The next planned traffic switch to the new traffic pattern is tentatively scheduled for the Week of 07/20/2026.

  • During paving operations, flaggers will be used to enhance safety for the traveling public.
  • The existing traffic pattern will remain in place during paving operations with possible lane closures aided with flaggers to perform required paving.
  • The traveling public is asked to observe the 25 MPH work zone speed limit while passing through the project area.
  • Flaggers may also be used during daytime operations to provide additional protection for the traveling public and to assist with truck ingress and egress within the work zone.



WVDOH Website, CLICK HERE:

WVDOH Cross Lanes project link with original traffic visualizations

NEW Traffic Pattern Sketch: CLICK HERE For New Pattern Beginning 7/20/2026.

Upcoming Traffic Control Switch 07-20-2026

Cross Lanes Widening

Latest News

Important project updates, announcements, and related local media stories.

10/13/2025 Update

Work on the project is progressing with minimal delays. Project is continuing to place curb and gutter, inlets, pipe and sidewalk as the primary items of focus. Work is being …

New Traffic Pattern 9/10/2025

Temporary Traffic Control Phase (2) will be in place beginning 9/10/2025 8:00 PM – WV 622 partial lane closure northbound beginning at I-64 West Bound Exit Ramp to Cadel Drive …

Project Update

July 28, 2025The Cross Lanes Widening Project is scheduled to resume construction beginning August 4, 2025.  Work will resume in the areas that are currently coned off from the Kroger …

April 02, 2025 Project Update

A few utilities remain throughout the project that still need to be relocated to allow contract work to proceed. Work on the project will be significantly minimized during the utility …

Update – Utilities

Various utilities throughout the project need to be relocated to allow contract work to proceed. Work on the project will be significantly minimized during the utility relocation efforts. The project …

New Phase of Construction

New Traffic Pattern!New Phase of Project has Begun.In the early A.M. hours of 6/14/2024 the Cross Lanes widening project made its second traffic switch for the phased construction.The current phase …

!!! Important Update !!!

Change in Start of New Traffic Pattern Reason For Change: The upcoming change in traffic pattern has been delayed, due to additional unforeseen work that requires additional time to perform.  …

Project Update – 05/13/2024

Notice of Traffic Pattern Change Location: WV 622 Big Tyler Road, Cross Lanes WV Scheduled Lane Shift: Beginning 5/15/2024, pending weather Description of Change: Due to the current construction along …
